Lesson 2: Scheduling Methods

Lesson 2: Scheduling Methods

Before working through how the critical path is calculated, it helps to understand the two main scheduling methods used in construction — and how the Critical Path Method builds on the simpler Bar Chart approach.


Bar Chart (Gantt Chart) Scheduling

A Bar Chart — also known as a Gantt Chart — is the simplest scheduling method. It defines the schedule using two variables:

1. Time

The calendar — when each activity starts and finishes, expressed as a duration on a horizontal time axis.

2. Scope

The activities or tasks — the list of work items that need to be completed to deliver the project.

Activities are shown as horizontal bars on a time axis. A Bar Chart is simple, visual, and easy to communicate — but it has one critical limitation: it does not show the logical dependencies between activities. There is no way to calculate which activities are truly critical or to determine the impact of a delay on the project end date.

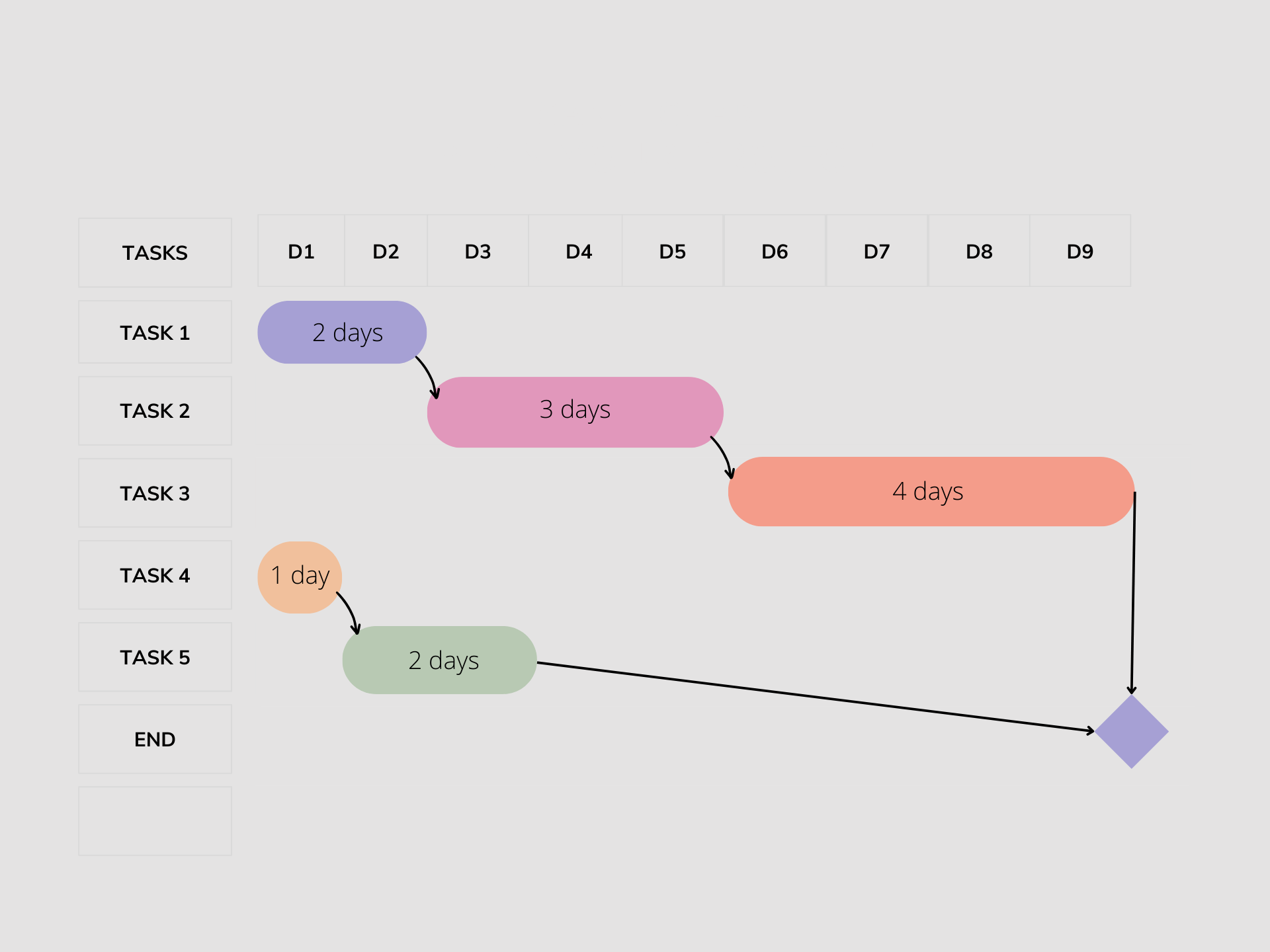

Example Bar Chart showing project activities as horizontal bars on a time axis
A Bar Chart (Gantt Chart) — Time and Scope only. No logic relationships between activities.

Critical Path Method (CPM) Scheduling

The Critical Path Method adds a third variable to the Bar Chart, fundamentally changing what the schedule can tell you:

1. Time

Duration and calendar — same as the Bar Chart.

2. Scope

Activities and tasks — same as the Bar Chart.

3. Logic

The relationships and dependencies between activities — which activities must be completed before others can begin.

By adding Logic, the schedule becomes a network. The software can now calculate Early Start, Early Finish, Late Start, Late Finish, and Total Float for every activity — and identify the Critical Path: the sequence of activities with zero float that drives the project end date.

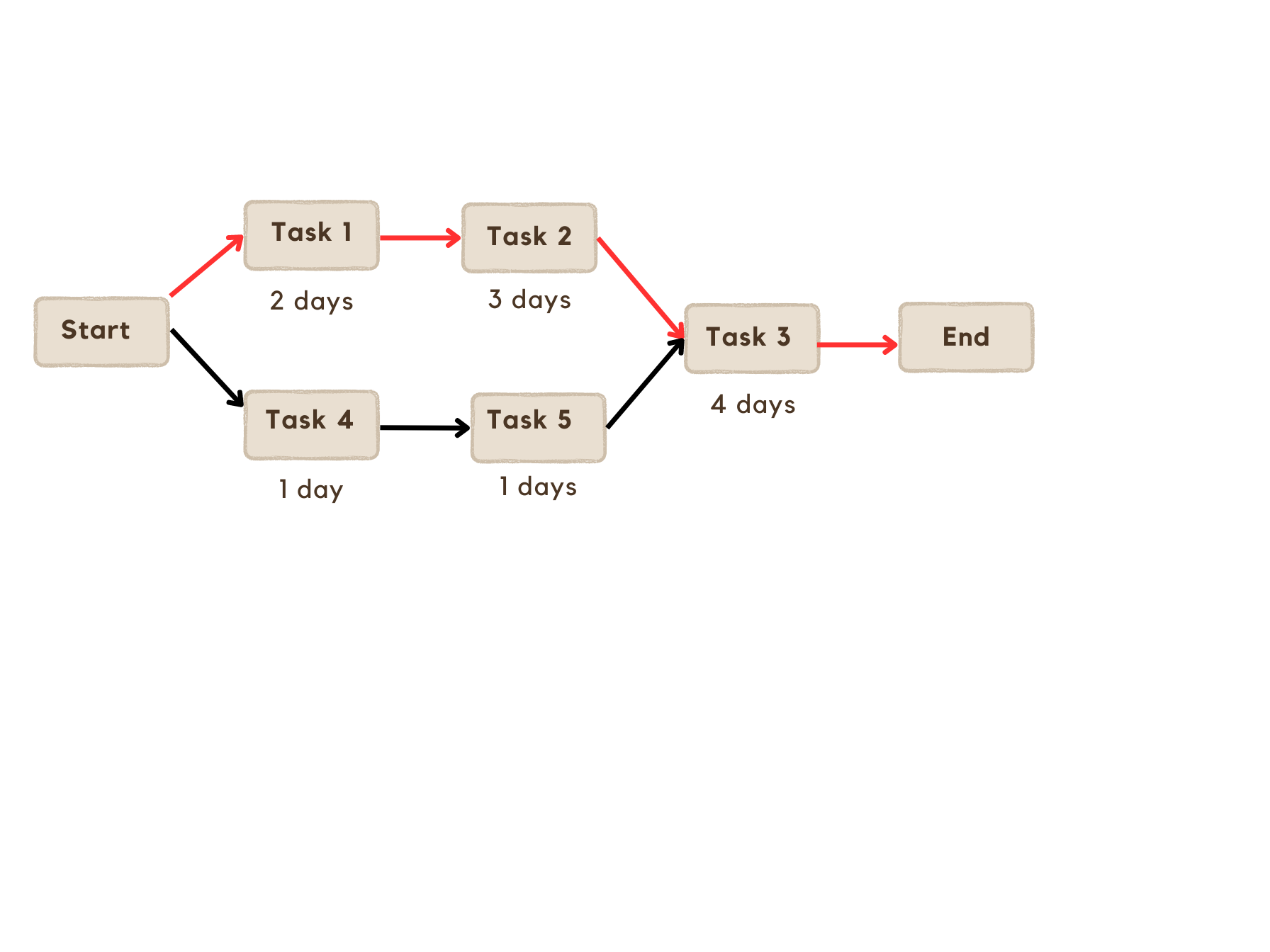

CPM schedule showing logic relationships (arrows) between activities in addition to the bar chart
A CPM Schedule — Time, Scope, and Logic. The addition of logic links enables critical path analysis.

Calculating the Critical Path — Manual Method

CPM scheduling software calculates the critical path automatically. But understanding the manual method helps you interpret the results, spot errors, and make better scheduling decisions. We'll work through a simple 5-activity example.

Step 1: Build the Activity Network

Start with a list of activities, their durations, and their dependencies. Build an Activity Network Diagram (Precedence Diagram) showing the flow from Start to End, with logic links as arrows. For each activity, create a node with spaces for the four key dates: ES, EF, LS, LF.

Activity network diagram with node cards showing spaces for Early Start, Early Finish, Late Start, and Late Finish
Activity network with node cards — one card per activity, ready for forward and backward pass calculations

Step 2: Forward Pass — Calculate Early Dates

Working left to right through the network, calculate the Early Start and Early Finish for each activity:

  • Early Start (ES) = the Early Finish of the preceding activity. Where there are multiple predecessors, take the latest Early Finish.
  • Early Finish (EF) = ES + Duration.
  • The project's earliest completion date is the EF of the final activity (or the latest EF of all final activities).

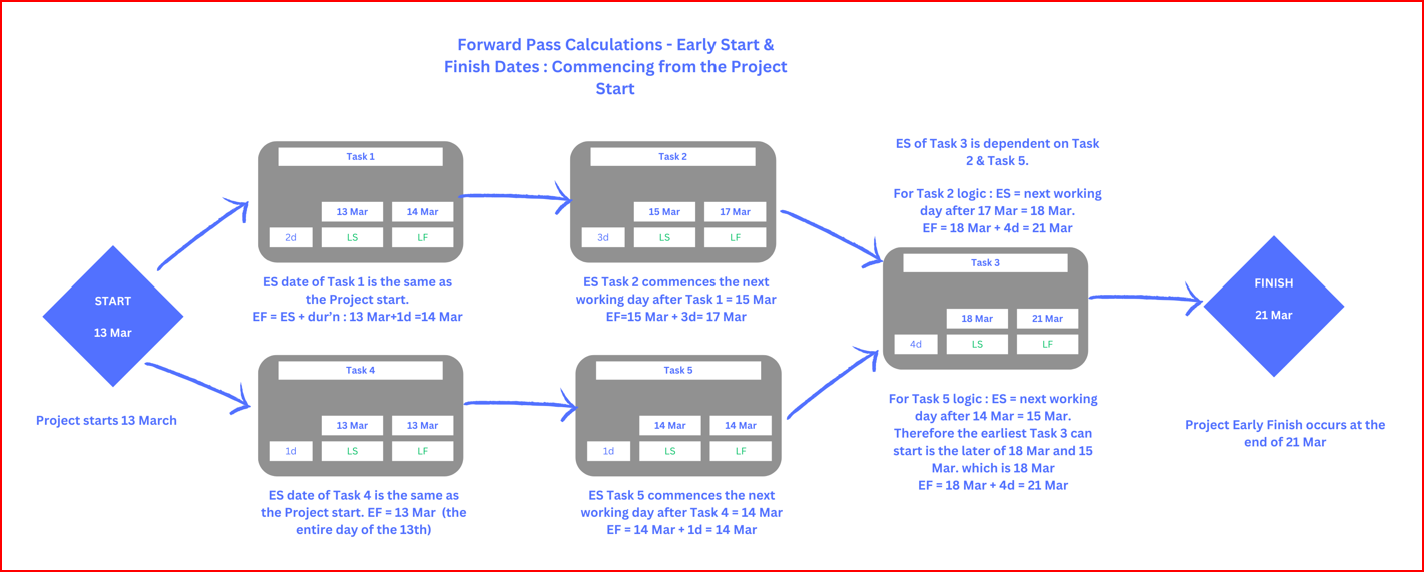

Forward pass calculations — Early Start and Early Finish filled in on each activity node, working left to right through the network
Forward Pass: Early Start and Early Finish calculated for every activity

Step 3: Backward Pass — Calculate Late Dates

Working right to left from the project end date, calculate the Late Finish and Late Start for each activity:

  • Late Finish (LF) = the Late Start of the succeeding activity. Where there are multiple successors, take the earliest Late Start. For the final activity, LF = project completion date.
  • Late Start (LS) = LF − Duration.

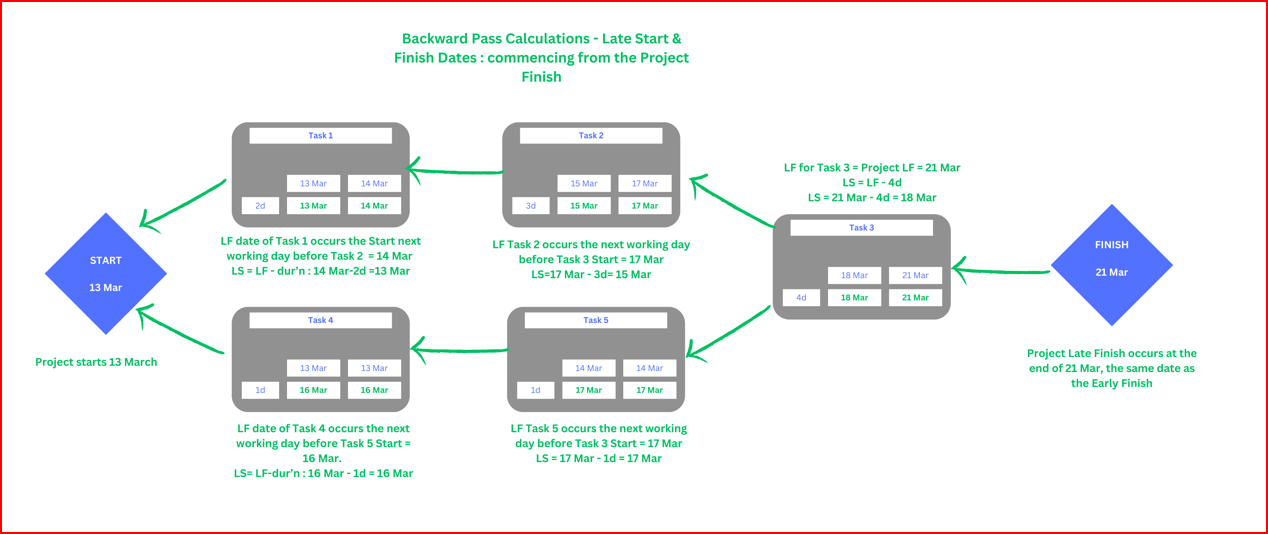

Backward pass calculations — Late Start and Late Finish filled in on each activity node, working right to left through the network
Backward Pass: Late Start and Late Finish calculated for every activity

Step 4: Calculate Total Float & Identify the Critical Path

For each activity: Total Float (TF) = LS − ES (or TF = LF − EF). Activities with zero float form the critical path — any delay to these activities delays the project finish date by the same number of days.

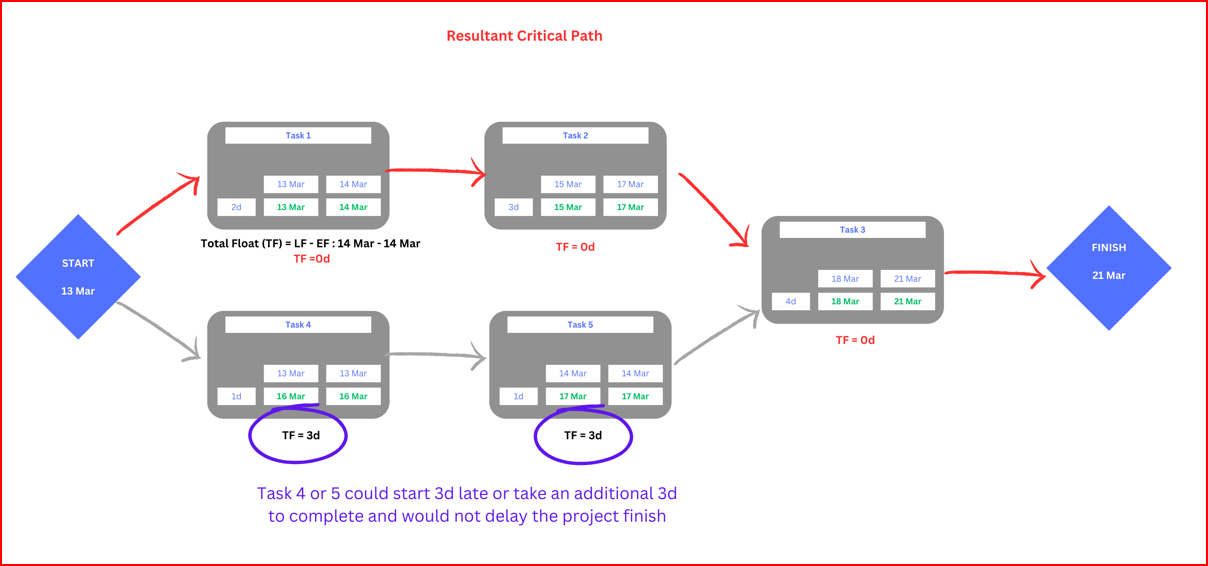

Completed network with Total Float calculated for each activity — critical path activities (TF = 0) shown highlighted in orange
Critical path identified — activities with TF = 0 form the critical path (shown highlighted). Non-critical activities have positive float.
Why understand the manual method?

Real construction schedules have hundreds or thousands of activities — CPM software handles the calculations. But understanding the forward and backward pass lets you interrogate the software output, identify logical errors, and explain the critical path clearly to clients and project teams.


CPM Scheduling Software

The three primary CPM scheduling software packages used in construction are Oracle Primavera P6, Microsoft Project, and Asta Powerproject (Elecosoft). Each performs the forward and backward pass calculations automatically — the difference lies in their architecture, capabilities, and typical industry application.

Oracle Primavera P6 software screenshot
Oracle Primavera P6
Microsoft Project software screenshot
Microsoft Project
Asta Powerproject software screenshot
Asta Powerproject

Origins

Oracle Primavera P6

Originated as Eagle Ray in the 1990s, later developed by Primavera Systems and acquired by Oracle. Designed from the outset for large, complex project management.

Microsoft Project

Developed in the US in 1984, initially targeting software development projects. Grew into a broadly adopted general-purpose project management tool.

Asta Powerproject

Developed in the UK in the early 1980s by Elecosoft, with a specific focus on building and construction scheduling from the outset.

Architecture

Oracle Primavera P6

Enterprise-grade relational database architecture (Oracle DB or SQLite). Supports multi-user access, role-based security, and portfolio-level project management across thousands of activities and multiple simultaneous schedules.

Microsoft Project

File-based architecture (.mpp files). Project Server / Project Online provides enterprise functionality, but the standalone desktop product is single-user. Part of the Microsoft 365 ecosystem.

Asta Powerproject

File-based or SQL Server-backed architecture. Supports multi-user via Asta Enterprise. Known for a flexible concurrent (floating) licensing model that reduces cost on large projects.

Industry Usage

Oracle Primavera P6

The industry standard for major infrastructure, oil & gas, mining, and large commercial construction. Required on most government and Tier 1 contractor projects in Australia.

Microsoft Project

Widely used by residential builders, architects, quantity surveyors, and smaller civil contractors. Valued for its simplicity, familiar interface, and low cost.

Asta Powerproject

Large commercial construction and building developers, particularly in the UK. Growing adoption in Australia. Valued for construction-specific features and cost-effective licensing.

Advantages & Disadvantages

Software Advantages Disadvantages
Primavera P6 Handles very large data sets; enforces correct update methodology (actual dates, remaining duration); robust baseline and forecasting tools; industry-standard for major projects; strong activity coding and filtering Graphical/Gantt view limitations; requires careful management of planned dates and baseline data; higher cost and IT complexity; steeper learning curve
MS Project Easy to use; widely recognised; cost-effective; simple deployment within Microsoft 365 environments; suitable for smaller projects Limited relationship modelling; challenges with complex multi-resource calendars and large schedule data sets; baseline management less robust than P6; not suited for major infrastructure projects
Asta Powerproject Extensive scheduling and visualisation options; construction-specific features (hammocks, task bars, free-float bars); cost-effective concurrent licensing; free project reader available Smaller market penetration in Australia; fewer skilled operators available; steeper learning curve for those moving from P6 or MS Project

In the next lesson we look at how the critical path is confirmed in practice — understanding total float thresholds, near-critical paths, and how the critical path evolves as a project progresses.
